Too many oversight programs rely on retrospective reviews, quarterly check-ins, or a project lead's gut feeling. By the time a status report reveals trouble, sites have gone weeks without support and the timeline has already slipped. This article breaks down the KPI categories that matter, the formulas behind them, the red flags to watch, and how to build an oversight framework that catches problems early instead of explaining them later.
Key Takeaways
- Enrollment delays affect roughly half of global trials, so early KPI tracking is essential
- No industry-standard CRO scorecard exists, so sponsors must define their own metric dictionary
- Leading indicators (staffing, query aging) catch problems before lagging indicators (missed milestones) confirm them
- Use site feedback and transparent data-sharing to catch issues dashboards miss
Why Tracking CRO Performance Matters
Weak CRO performance rarely stays contained. Late site activation eats into recruitment windows, while sluggish query resolution piles up data cleaning work ahead of database lock. Left unaddressed, these issues can force sponsors into a mid-study "rescue" CRO transition that drains budget and stalls timelines.
Part of the challenge is structural. Applied Clinical Trials reported that the industry still lacks a standardized measurement framework for CRO and vendor oversight. There's no off-the-shelf scorecard sponsors can simply adopt. Every sponsor has to build their own.
That means being deliberate about what you measure and why. Good scorecards separate:
- What the CRO controls — staffing continuity, query turnaround, monitoring report timeliness
- What the sponsor or study design controls — protocol complexity, indication rarity, site selection criteria
Blending these together produces unfair comparisons and unclear accountability. A CRO shouldn't be penalized for slow enrollment in a rare-disease trial with a naturally small patient pool, but they should be accountable for how quickly they escalate that risk once it's visible.
Core KPI Categories Every Sponsor Should Track

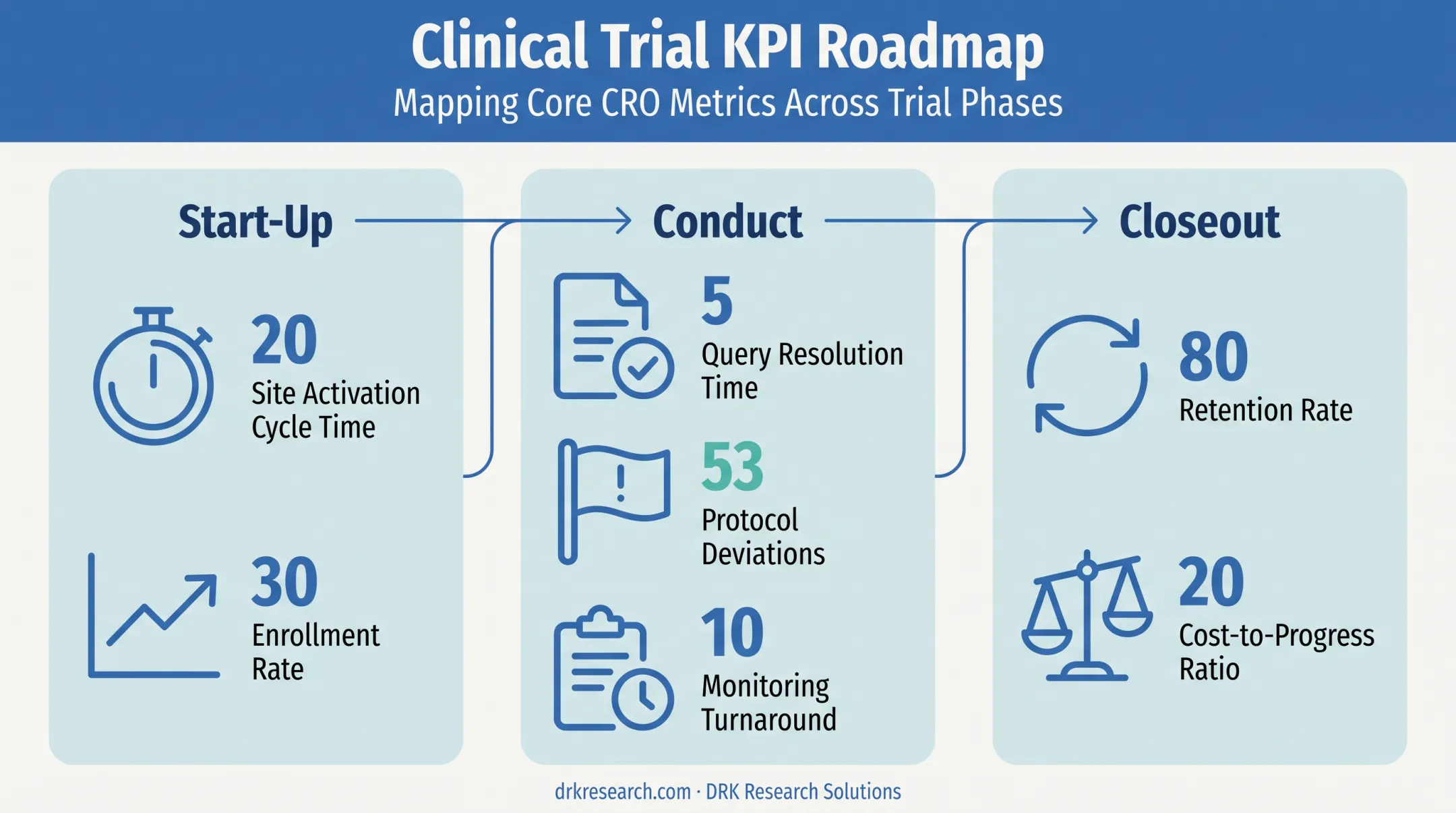

KPIs should map to study phase, not just get thrown onto one giant dashboard. Start-up, conduct, and closeout each carry different risks, and tracking everything indiscriminately buries the signals that matter.
Timeliness & Cycle Time Metrics
Site activation cycle time measures the days between submission (contract, IRB, or final protocol approval, whichever your team defines as the start date) and first patient enrolled. Delays here compound: every week lost at activation is a week the site never gets back for recruitment.

Enrollment rate vs. forecast is calculated as:
(Actual enrollment / Forecasted enrollment) x 100
There's no universal industry threshold for an acceptable variance. Sustained performance below roughly 80% of forecast, without a corrective action plan, typically warrants a formal mitigation conversation.
Patient retention rate bookends enrollment and reflects how well sites manage protocol burden and participant engagement:
(Participants completing the defined study period / Participants enrolled) x 100
Report the follow-up period explicitly, and decide upfront how you'll treat withdrawals, deaths, and lost-to-follow-up cases. Retention percentages vary widely by indication and design, so benchmark against your own study assumptions rather than a generic industry number.

Quality & Compliance Metrics
Data quality shows up in a few key places:
- Query resolution time — how long queries stay open, and the share open beyond 30 days; a proxy for data management responsiveness
- Protocol deviation rates — deviations per participant or per visit, separating "important" deviations (per FDA's guidance) from minor ones
- Monitoring visit report turnaround — days between site visit and finalized report; signals CRA workload and discipline
Rising numbers in any of these categories usually mean the same underlying thing: the team supporting your trial is stretched thin.
Cost & Resource Metrics
Scope creep and cost overruns rarely show up all at once. Track sponsor- or CRO-initiated scope changes cumulatively against the original SOW, and watch cost incurred relative to study progress. Spending 60% of budget at 40% of enrollment is a signal worth investigating.

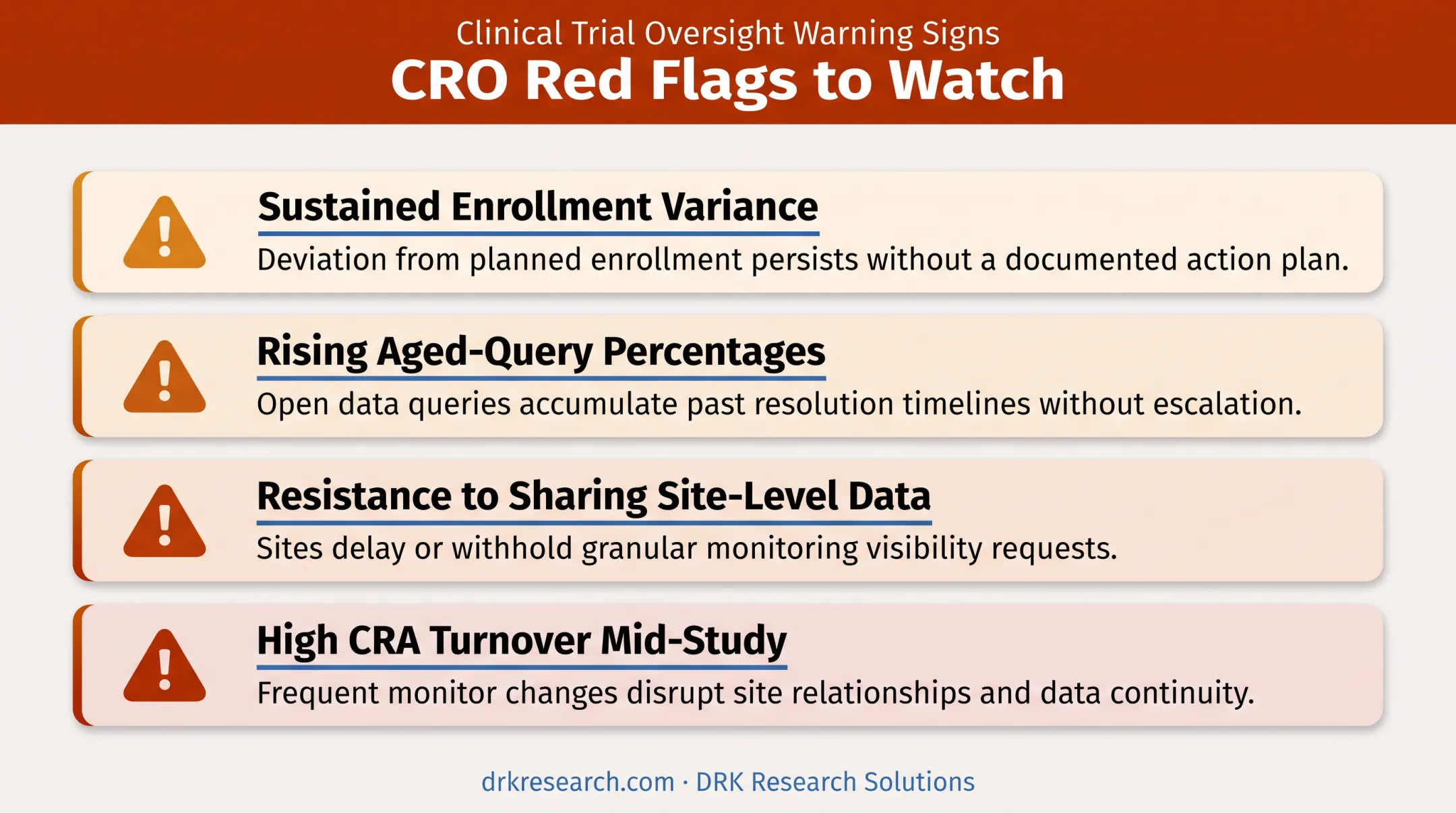

Red Flags That Signal CRO Underperformance
Some warning signs are obvious only in hindsight. Watch for these earlier:
- Sustained enrollment variance below target without a corrective action plan. A single bad month happens. Three months without a mitigation strategy is a pattern.
- Rising aged-query percentages or late monitoring reports. These often trace back to CRA turnover or resource strain that hasn't been disclosed yet.
- Resistance to sharing granular site-level data. A CRO that offers only rolled-up summaries, or blames delays without root-cause analysis, may be masking real performance issues.
- High CRA or project lead turnover mid-study. Reported CRA turnover can run as high as 30% in the US, and new hires can take nine months to reach proficiency. Every departure risks losing institutional knowledge and site relationships built over months.
None of these signals is disqualifying on its own. Together, or left unaddressed, they're a pattern worth escalating.

Beyond the Numbers: Why Site Perspective and Governance Matter
Dashboards tell you what happened. They rarely tell you why. A site struggling with a clunky eCRF, unresponsive CRA communication, or unclear query instructions won't necessarily show up as a red metric until it's already affected data quality.
Site feedback fills that gap. Industry analysts have called sites an overlooked voice in CRO assessment, and for good reason: sites feel operational friction long before it hits a sponsor dashboard.
Structured site surveys or a site ambassador channel give you an early-warning system that quantitative KPIs can't replicate. Treat those signals as part of governance—not optional color commentary—by defining who reviews them and when escalation is required.
Pair that with a simple status framework:
- Green: metric within threshold
- Amber: approaching threshold, requires monitoring
- Red: breached threshold, requires action plan
Keep the number of tracked metrics small. A traffic-light dashboard with 30 KPIs is just noise. One with 8-10 well-chosen metrics, agreed with the CRO before study start, makes performance drift visible fast.

Building an Effective CRO Oversight Framework
Effective CRO oversight depends on tracking the right metrics with clear ownership and accountability.
- Define a small KPI set at contract signing. Assign an owner to each metric, agree on reporting cadence, and define escalation steps for breached thresholds—all before the study starts.
- Distinguish leading from lagging indicators. Leading indicators, like site activation pipeline health or CRA staffing continuity, let you correct course during the current trial. Lagging indicators, like final enrollment variance or database lock timing, mainly inform how you select CROs next time.
- Choose partners with genuine multi-regional experience. Trials that span multiple regulatory environments, or reach underserved and LMIC populations, need operational maturity that reduces your oversight burden rather than adding to it.
This is where CRO selection intersects with oversight design. DRK Research Solutions runs GxP-compliant clinical operations across Europe, the Middle East, Asia, Africa, and the Americas, with local-language teams and regulatory expertise suited to multi-regional complexity. That footprint does not remove the need for KPI tracking, but it does mean fewer surprises when your trial reaches sites your internal team cannot visit every quarter.
Frequently Asked Questions
What is the difference between a metric and a KPI in clinical trials?
A metric is any measurement you track, like total queries issued. A KPI is a metric specifically selected because it's tied to a target, an owner, and a decision, such as query aging beyond 30 days.
How often should sponsors review CRO performance metrics?
Operational metrics like query aging and site activation should be reviewed monthly. Broader trend analysis and governance decisions typically happen quarterly, aligned to study phase.
What is considered a good enrollment variance threshold?
There's no universal cutoff, but sustained performance below roughly 80% of forecast, without a mitigation plan, is a common trigger point for a formal escalation discussion.
How can sponsors detect a CRO in trouble before it becomes a crisis?
Watch leading indicators rather than final outcomes: site activation delays, rising query backlogs, and unexplained CRA turnover all surface before enrollment numbers do.
Should sponsors involve clinical sites in evaluating CRO performance?
Yes. Sites see communication gaps, technology friction, and workload issues long before those problems appear in a sponsor-facing dashboard.
What happens if a CRO consistently underperforms against agreed KPIs?
Sponsors should escalate through a root-cause review and a documented corrective action plan. If performance doesn't improve, transitioning to a rescue CRO becomes the next step.
