Clinical Trial Site Activation: Common Bottlenecks and How to Resolve Them Site activation is the bridge between choosing a site and enrolling your first patient. It's also where trial timelines quietly fall apart.

Get it right, and a sponsor moves from contract to first-patient-in in weeks. Get it wrong, and a single site can stall an entire study while budgets bleed. Delays here stem from predictable culprits: regulatory bottlenecks, contract standoffs, staffing shortfalls, and technology that doesn't talk to itself.

This article breaks down the five most common activation bottlenecks, why they happen, a practical framework for fixing them, and when it makes sense to bring in outside help.

TL;DR

  • Most activation delays trace back to four categories: regulatory/ethics review, contracts, documentation, and staffing
  • Process changes resolve most bottlenecks; outside support is usually needed only for complex multi-regional trials
  • Diagnose first: locate the delay, then apply a targeted fix
  • Bring in a CRO partner when internal teams lack regional regulatory relationships or bandwidth

What Is Clinical Trial Site Activation?

Site activation is the process of getting a selected site legally, ethically, and operationally ready to enroll participants. Three parallel workstreams all need to close out before enrollment opens:

  • Regulatory and ethics approval — IRB/EC sign-off, documented per FDA's E6(R3) guidance, which requires approval before any enrollment activity begins
  • Contract and budget negotiation — the Clinical Trial Agreement (CTA), indemnification terms, and payment schedule
  • Site training and initiation — staff onboarding, delegation logs, equipment checks, and the site initiation visit

Activation is cross-functional by nature. Sponsors, CROs, sites, and regulatory bodies all hand work back and forth, and each handoff is a place where things can stall.

Common Bottlenecks in Site Activation

Most delays fall into a handful of recurring patterns. Here's what they look like on the ground.

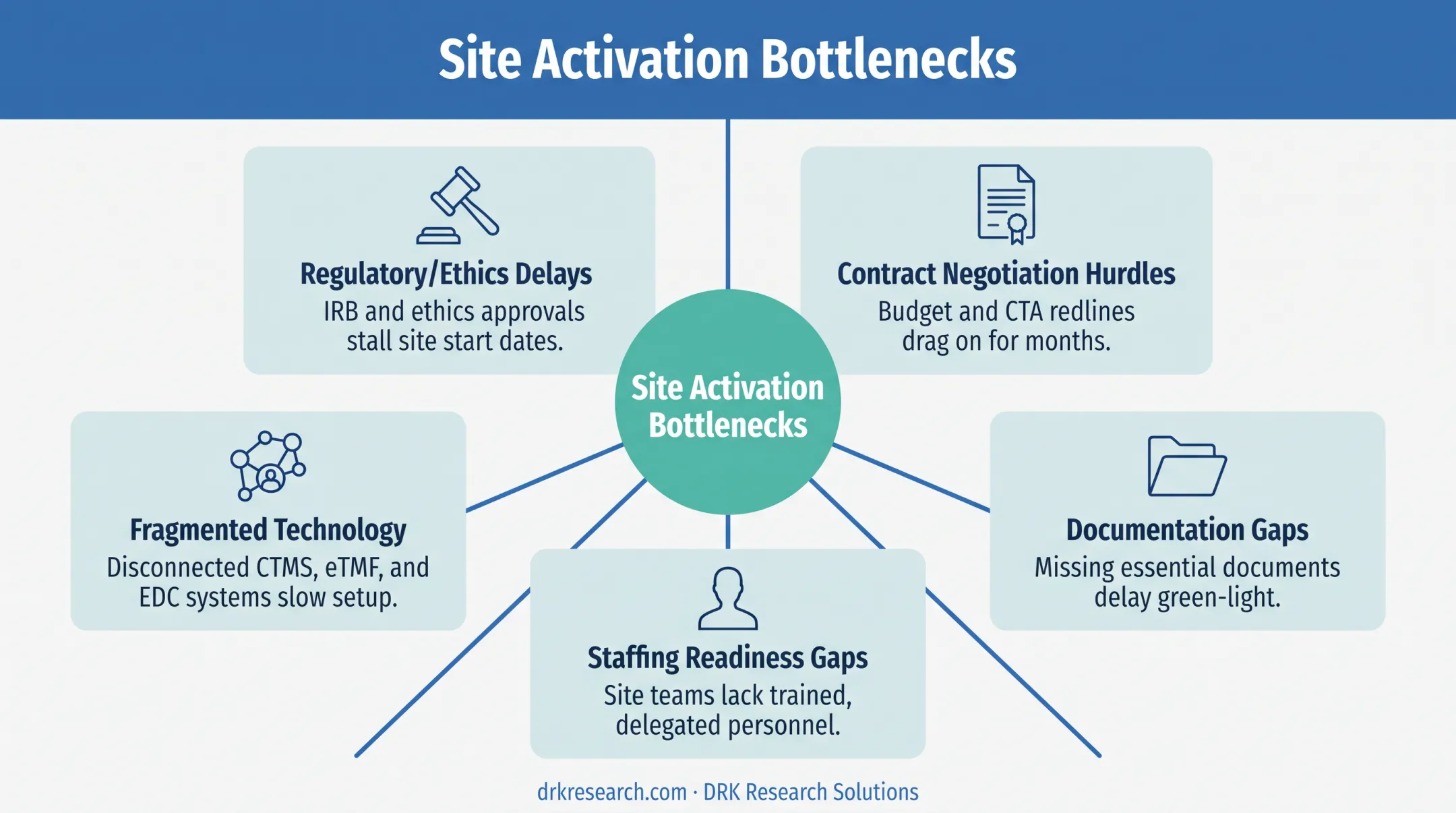

Five common clinical trial site activation bottlenecks overview diagram

Regulatory and Ethics Committee Delays

Symptoms:

  • Extended review cycles
  • Repeated information requests
  • Inconsistent requirements between regions

Likely cause: Incomplete submissions or unfamiliarity with local nuances. WCG's 2024 data shows typical US timelines of about one week for exempt review, two to four weeks for expedited, and four to six weeks for full-board review. Incomplete applications and missing consent language routinely push these timelines longer.

Contract and Budget Negotiation Hurdles

Symptoms:

  • Multiple redline rounds
  • Stalled CTAs
  • Unresolved indemnification or IP language

Likely cause: No standardized templates. A 2023 study in the Journal of Clinical and Translational Science found that standard agreements cut mean CTA negotiation time from 55 days to 22 days when master terms were used upfront.

Documentation Gaps and Miscommunication

Symptoms:

  • Missing CVs, financial disclosures, and delegation logs
  • Endless document chasing
  • Unclear handoffs across teams

Likely cause: No centralized tracking system, and no clear owner among sponsor, CRO, and site.

Site Staffing and Readiness Gaps

Symptoms:

  • Delayed training completion
  • Unavailable principal investigators
  • Overstretched coordinators

Likely cause: A shrinking, more overcommitted PI pool. Tufts CSDD found the number of active US investigators dropped 11.4% between 2001 and 2003, while PI turnover nearly doubled. That shortage has only intensified competition for investigator time since.

Fragmented Technology and Data Silos

Symptoms:

  • Duplicate data entry
  • Lost document versions
  • No shared view of activation status across sites

Likely cause: Disconnected CTMS, eRegulatory, and communication tools that don't share a single source of truth.

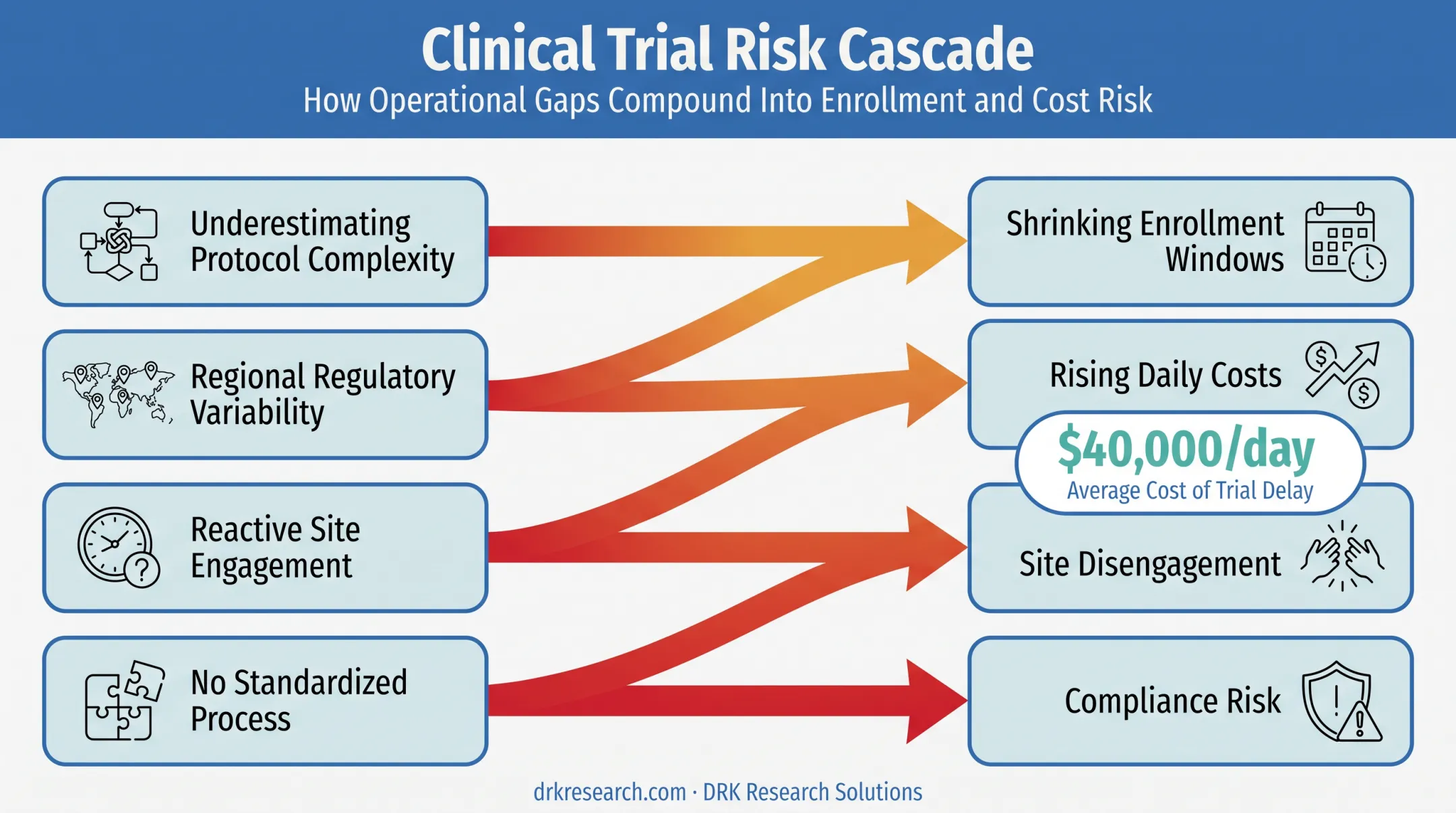

Root causes of site activation bottlenecks and their downstream impact

Why Site Activation Bottlenecks Happen (Root Causes)

These symptoms aren't random. They usually trace back to a few systemic conditions:

  • Underestimating protocol complexity during early planning
  • Regional regulatory variability that catches teams off guard
  • Reactive site engagement instead of proactive relationship-building
  • No standardized process reused across studies

Left unresolved, these issues compound and enrollment windows shrink. Tufts CSDD estimates direct trial costs at roughly $40,000 per day for Phase II/III studies, money spent whether or not a single patient has enrolled.

Beyond cost, delayed sites disengage, sponsors scramble to add "rescue" sites, and rushed activation raises compliance risk.

How to Resolve Site Activation Bottlenecks (Step-by-Step)

Fixing bottlenecks starts with diagnosing where the delay occurs. A generic fix applied in the wrong place can create new problems elsewhere.

Step 1: Diagnose Where the Delay Is Occurring

  • Map the current activation timeline against planned milestones, site by site
  • Identify which handoff point — regulatory, contract, training, or technology — is holding things up
  • Talk directly to site coordinators and investigators about what's actually blocking them

Step 2: Categorize the Root Cause

Determine whether the bottleneck is regulatory, contractual, operational, or technological. Then check scope:

  • One site's problem — resolve it with that site's coordinator and investigator
  • Pattern across every site — fix the sponsor or CRO process before adding sites

Adding more sites will not fix a broken internal contracting process.

Step 3: Apply the Targeted Fix

If regulatory/ethics-related:

  • Engage IRBs/ECs early with pre-submission meetings and complete packages
  • Use centralized or expedited review pathways where they exist

If contract/budget-related:

  • Deploy standardized CTA and budget templates with pre-approved fallback terms
  • Build master service agreements with repeat high-performing sites

If staffing/training-related:

  • Offer remote or on-demand training to sidestep scheduling conflicts
  • Assess site capacity honestly before activation; add a co-investigator if needed

If technology/documentation-related:

  • Consolidate documents and communication into one eClinical or CTMS platform
  • Automate status tracking and reminders for outstanding items

Step 4: Validate Activation Readiness

  1. Confirm regulatory approvals, executed contracts, and training are fully documented
  2. Conduct a final site initiation visit to check equipment, supply, and system readiness
  3. Track early enrollment against projections to catch residual issues fast

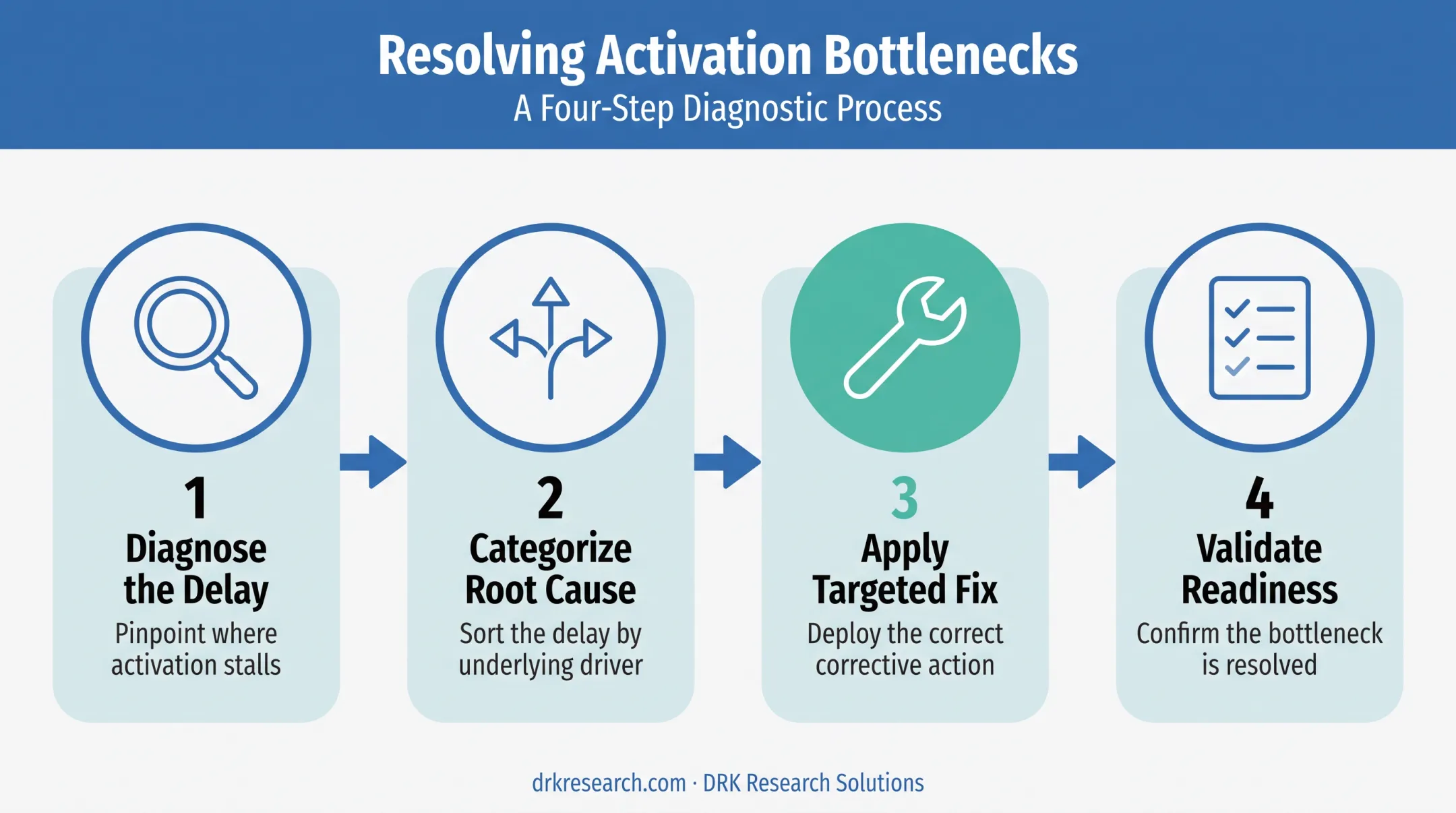

Four-step framework for resolving clinical trial site activation bottlenecks

When to Handle Activation In-House vs. Bring in a Specialized Partner

The right call depends on internal bandwidth, regional complexity, and how much risk you're willing to absorb.

Single-country trial with familiar sites:

  • Handle in-house if you already have working relationships and standard protocols
  • Bring in a partner if your regulatory or contracts team is already stretched thin

Multi-regional or emerging-market expansion:

  • Handle in-house only if you have established regional infrastructure
  • Bring in a partner where in-country regulatory relationships and pre-vetted sites matter most

Income level alone doesn't predict delay. A sub-analysis of the APHINITY trial found median regulatory approval times of 45 days in high-income countries versus 92 days in upper-middle-income countries, though the difference wasn't statistically significant.

Regulatory approval timelines comparison across income-level countries chart

Local regulatory relationships and review architecture do.

That's the gap a CRO with established regional presence can close. DRK Research Solutions operates across Europe, the Middle East, Asia, Africa, and the Americas, with local leadership and language capability in each region. For sponsors expanding into unfamiliar regulatory territory, that on-the-ground presence removes the guesswork that otherwise slows activation.

Common Mistakes to Avoid When Resolving Bottlenecks

Under activation pressure, teams often reach for quick fixes that mask the delay instead of removing it. Avoid these common missteps:

  • Adding "rescue" sites to offset slow enrollment instead of fixing the activation delay itself
  • Treating documents and contracts as one-off fixes instead of building repeatable, standardized processes
  • Skipping site staff input when diagnosing delays — they usually know exactly where the friction is

Fix the root cause first. Workarounds rarely recover lost activation time.

Preventive Measures to Avoid Future Activation Delays

Proactive planning shortens timelines and lowers per-site costs. A few habits make the biggest difference:

  • Start activation planning during protocol design, not after site selection
  • Standardize CTAs, budgets, and documentation checklists across every study
  • Use integrated CTMS/eRegulatory platforms for real-time visibility across sites
  • Build long-term relationships with high-performing sites to speed up repeat activations

Frequently Asked Questions

What is required before site initiation in a clinical trial?

Sites need executed contracts, regulatory and ethics approval, completed staff training, and verified supply and equipment readiness. All four must be documented before enrollment can legally begin.

What happens at a site initiation visit?

The visit covers protocol review, discussion of recruitment strategy, and verification of documentation, systems, and supplies. It's the final checkpoint before enrollment opens.

How long does clinical trial site activation typically take?

Timelines range from a few weeks to several months, depending on region and site type. Academic medical centers often take longer than independent research sites due to institutional review layers.

What is "just-in-time" site activation?

It involves pre-negotiating agreements and preparing non-protocol-specific documents, like CVs and licenses, before final protocol approval. This lets sites move faster once the protocol clears.

How can sponsors reduce site activation delays in emerging markets?

Local regulatory expertise, pre-vetted site networks, and early engagement with in-country partners all help. Review architecture and parallel processing often matter more than a country's income classification.

What role does technology play in speeding up site activation?

CTMS, eRegulatory, and e-consent platforms reduce manual errors and give every stakeholder visibility into status. The real gains come from pairing these tools with redesigned, parallel workflows, not from software alone.
