Clinical Trial Approval Process by Country: What Sponsors Need to Know Picture this: a sponsor has funding secured, sites identified, and drug supply ready for a five-country trial launch. Six months later, they're still waiting on approvals in two markets, watching their competitive window close.

This scenario plays out constantly. Clinical trial approval isn't one process — it's a patchwork of national regulatory reviews, ethics committee decisions, and administrative requirements that rarely align on timing.

This article breaks down how approval actually works across the US, EU/UK, and Asia-Pacific, what drives timeline variability, and how sponsors can avoid the delays that stall multi-country launches.

Key Takeaways

  • Both regulatory sign-off (FDA, EMA, NMPA) and ethics committee review are required in nearly every country
  • Timelines span under 30 days (Australia CTN) to 60+ business days (China CTA)
  • Budget for IND/CTA submission, GCP compliance, ethics review, and document localization
  • Multi-country programs move faster with local regulatory expertise or a CRO running parallel submissions

What Is the Clinical Trial Approval Process?

Clinical trial approval is the formal regulatory and ethical review a sponsor must complete before dosing a single human participant with an investigational product in a given country.

Regulators and ethics bodies verify three core requirements:

  • Nonclinical safety data supports human testing
  • Trial design will generate meaningful, interpretable results
  • Participant protections meet the country's human-subject standards

This is not the same as marketing approval. An NDA or MAA comes after trial completion, based on full efficacy and safety data. Clinical trial approval happens before a single patient enrolls. It authorizes human testing to begin, not commercial sale.

Why the Approval Process Differs by Country

Regulatory Divergence Despite Global Standards

Most countries follow ICH-GCP principles as a common foundation. Yet each retains its own agency, legal framework, and submission format.

The scale of this fragmentation matters. GlobalData's analysis via Clinical Trials Arena found that APAC accounted for more than 50% of global trials conducted between 2017 and 2021. That volume alone forces sponsors to understand region-specific processes. You can't treat APAC as an afterthought when it represents half the global trial landscape.

What This Means for Global Sponsors

Submission format differences, local data mandates, and consent-form language requirements can silently add weeks or months if unplanned for.

Some markets go further. Japan and China often require local patient data before approving later trial phases.

That requirement has direct consequences for trial design:

  • Build local cohorts into the global protocol from the start, not as a later add-on
  • Budget for upfront design; retrofitting a protocol for country-specific data costs far more

How the Approval Process Works Across Key Regions

United States

The FDA's IND application covers three areas: animal pharmacology/toxicology data, manufacturing information, and the clinical protocol package (including investigator qualifications and IRB commitments).

Once submitted, sponsors face a 30-calendar-day waiting period before dosing can begin. This is FDA's window to flag safety concerns or issue a clinical hold. But that 30-day clock is just the regulatory piece.

FDA's IRB guidance makes clear that IRB review and approval is a separate, mandatory gate. Don't assume day 31 means you're cleared to dose: your IRB and site readiness need to align too.

European Union & United Kingdom

The EU's Clinical Trials Regulation (536/2014) replaced the old Directive system in January 2022. Since January 2023, all new applications go through CTIS, a single portal covering up to 30 European countries. Official EU assessment guidance sets a baseline of 45 days for Part I/II review, extendable by 31 days if regulators issue a request for information.

The UK runs its own combined review outside CTIS. Post-Brexit, MHRA and the Research Ethics Committee (REC) issue a joint decision. Current HRA guidance targets validation within 1 working day and a combined decision within 30 calendar days of validation — though an RFI can add up to 60 days for sponsor response.

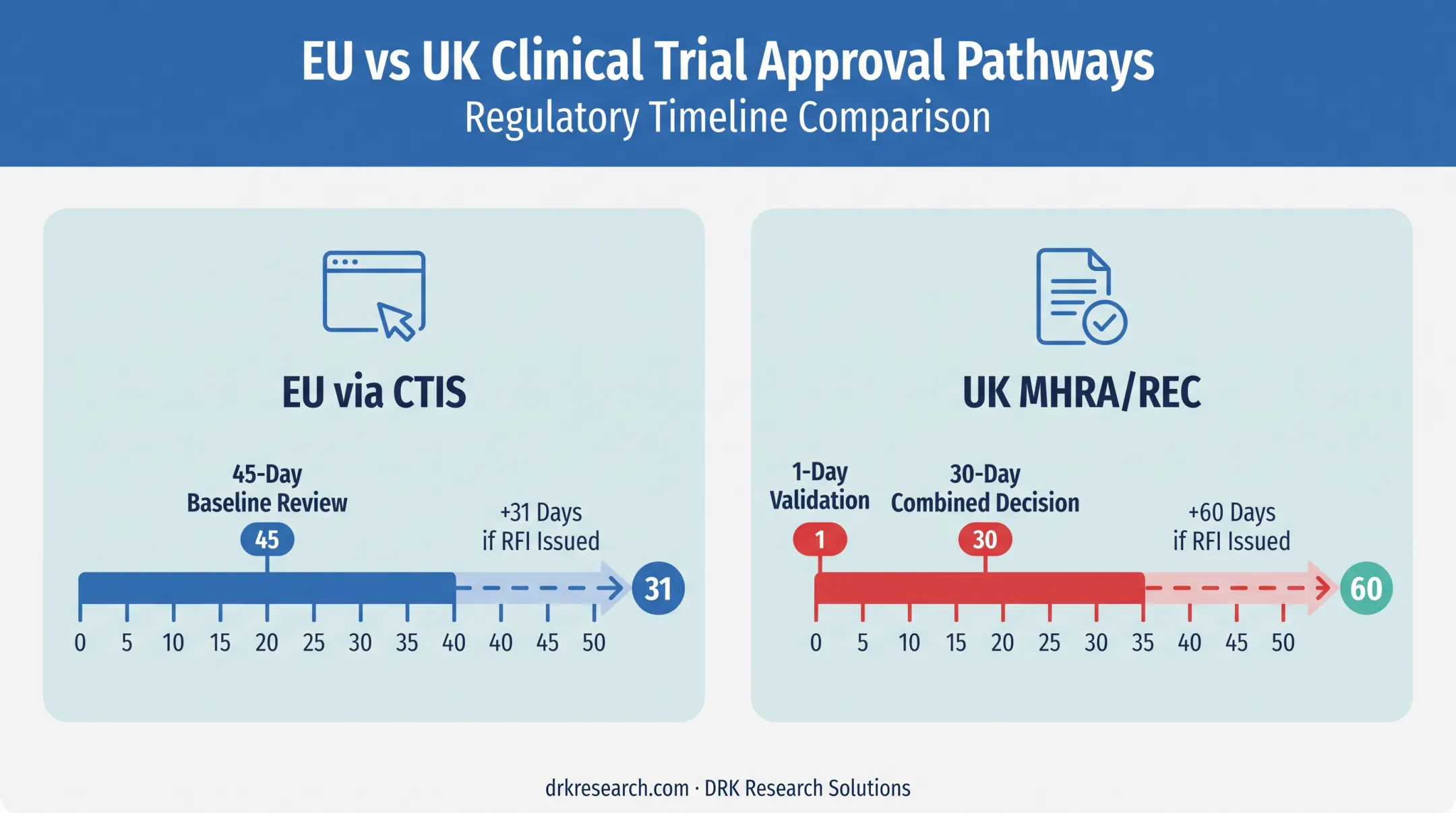

EU CTIS versus UK MHRA clinical trial approval process timeline comparison

Asia-Pacific (Japan, China, Australia)

APAC timelines vary more than any other region:

Market Approval Mechanism Key Detail
China CTA review 60-business-day default timeline per NMPA
Japan PMDA CTN checklist 30-day checklist for oncology notifications specifically
Australia CTN scheme TGA doesn't review trial data at submission; HREC and institution remain the real gates
Australia CTA scheme TGA reviews limited scientific data before trial start

Asia-Pacific clinical trial approval timelines comparison across China Japan Australia

China's 60-day window is a stated regulatory review clock, not a guarantee. Incomplete dossiers restart it. Australia's speed advantage comes from shifting the burden to ethics committees and institutions, not from a faster regulator.

Emerging & Underserved Markets

Regions like Sub-Saharan Africa and parts of the Middle East have regulatory frameworks that are actively maturing. The African Vaccine Regulatory Forum (AVAREF) now connects all 55 African countries through joint reviews, scientific advice, and evaluator training. That is real infrastructure, but still uneven in practice from country to country.

The Middle East faces a related challenge. A WHO Eastern Mediterranean consultation flagged multiple overlapping ethics committees, delayed clearances, and limited trial expertise as persistent bottlenecks.

Sponsors in these markets need a global network with regional expertise. DRK Research Solutions operates hubs across Europe, the Middle East, Asia, and the Americas, and supports trial activity across Africa. That footprint helps sponsors navigate markets where regulatory maturity is still developing.

Key Factors That Affect Approval Timelines

Regardless of country, a handful of variables consistently drive delays:

  • Incomplete dossiers restart review clocks when nonclinical or manufacturing data is missing
  • Local or ethnic bridging studies may be required in Japan and China before later-phase approval
  • Certified local-language translations of consent forms and submission documents add prep time
  • Sequential ethics-then-regulatory review costs months versus parallel review where permitted
  • Country-specific fees and investigational product import permits create unexpected lead time

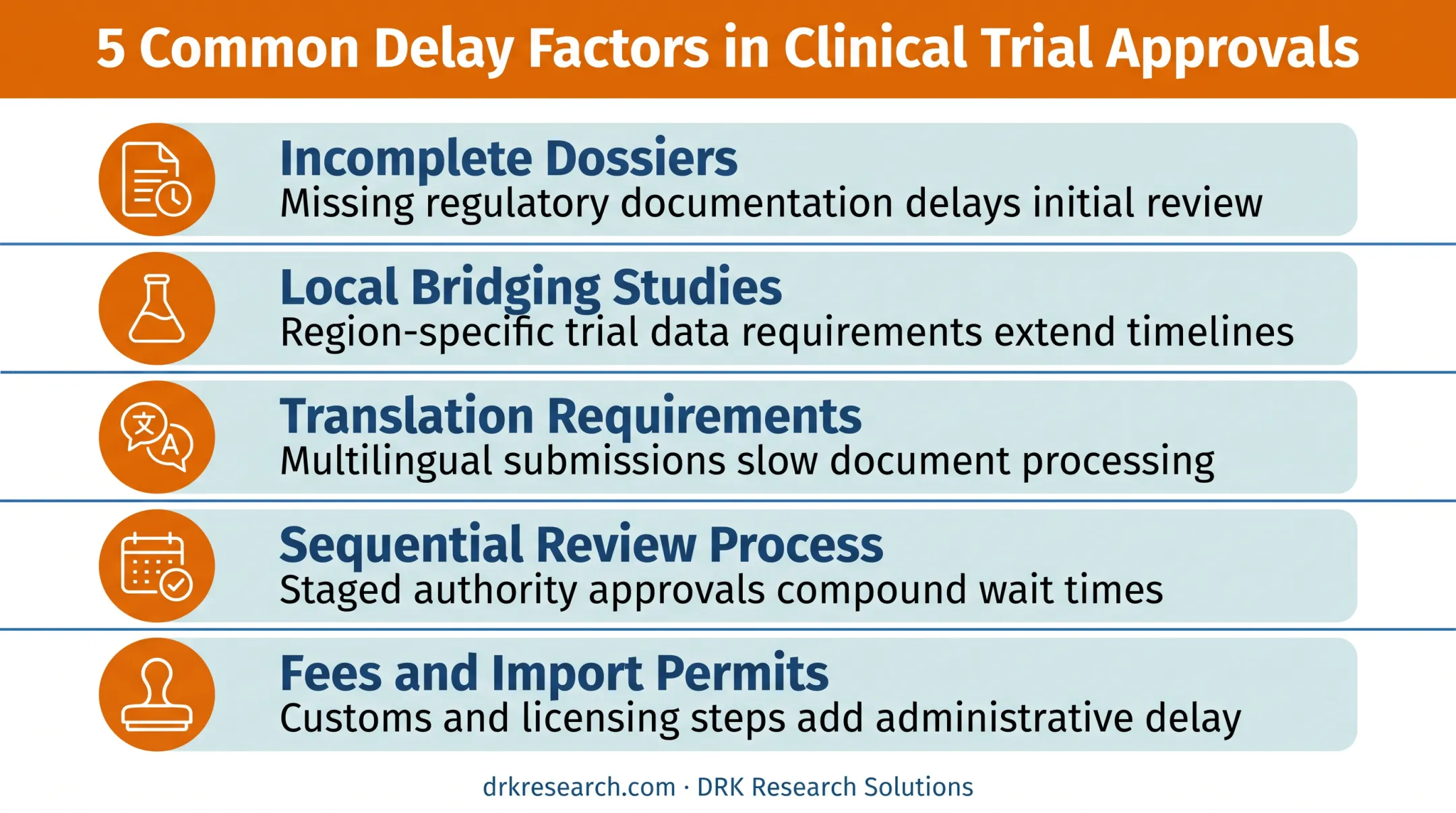

Five key factors causing clinical trial approval timeline delays

Common Mistakes Sponsors Make in Multi-Country Approvals

Even experienced sponsors trip on these:

  • Assuming one dossier format works everywhere: a US-formatted IND package rarely transfers cleanly to EU or APAC submission requirements
  • Underestimating translation timelines: certified translation and back-translation of consent forms take longer than most sponsors budget for
  • Defaulting to sequential submissions: when parallel ethics and regulatory review is allowed, running them sequentially wastes real time
  • Overlooking post-approval obligations: safety reporting cadence and local representative requirements differ by country and catch sponsors off guard after launch A single formatting mistake in a submission can cost months and add substantial expense to a program. Upfront country-specific planning prevents that setback.

Conclusion

Clinical trial approval is a sequence of country-specific regulatory and ethical checkpoints, each with its own timeline, documentation rules, and review logic. Sponsors who map these differences before launch protect their timelines; those who don't discover the gaps mid-trial, when they're expensive to fix.

DRK Research Solutions works with sponsors navigating exactly this complexity, drawing on regional teams across Europe, the Middle East, Asia, Africa, and the Americas to help manage country-specific approval nuances as part of end-to-end clinical trial support.

Frequently Asked Questions

What are the 5 phases of FDA approval?

The FDA pathway runs from preclinical testing through Phase I (safety), Phase II (efficacy/dosing), and Phase III (large-scale confirmation) before an NDA/BLA review, then Phase IV post-market monitoring after approval.

What is a key difference between the European and US drug approval processes?

The EU uses CTIS, a centralized system under one regulation covering up to 30 countries. The US relies solely on FDA's IND-to-NDA pathway, with no equivalent multi-country portal.

Which country conducts the most clinical trials?

The United States hosts a large share of registered trials, but APAC as a region has driven the fastest growth, accounting for more than 50% of conducted trials from 2017–2021.

Who approves clinical trials in Europe?

Approval requires two things: a national competent authority decision issued through CTIS, and an independent ethics committee opinion. Both must be positive before a trial can start.

How long does clinical trial approval typically take?

Timelines range from under 30 days under Australia's CTN scheme to 60+ business days in China's CTA process, depending on dossier completeness and local data requirements.

Do sponsors need local partners to run trials in multiple countries?

It's not always legally required, but local regulatory and ethics expertise significantly reduces delays and compliance risk when managing submissions across several countries simultaneously.
